General

Q1. What is the definition of MiC in particular of the freestanding volumetric modules stated in PNAP ADV-36?

A1.

The ultimate goal of adopting MiC is to improve site safety, efficiency and quality control, shorten construction period, reduce construction waste, disturbance and nuisance to the neighbourhood, etc.  Authorized Persons (APs) and Registered Structural Engineers (RSEs) should satisfy themselves that these benefits are practicably achievable and demonstrate in the plans submitted (e.g. MiC GBP and MiC superstructure plan) that there is improvement in the use of MiC as compared with the traditional insitu construction method.  The consideration of the extent of use of MiC as compared with the traditional insitu construction is shown in Figure 1.  APs/RSEs are strongly recommended to demonstrate this in the plans submitted.   APs and RSEs are also encouraged to make use of the pre-submission enquiry service or arrange an informal meeting with the TS/Building and TS/Structural of the Buildings Department (BD) on the enquiries related to building and structural matters respectively. The contact details are given in this webpage: https://www.bd.gov.hk/en/resources/codes-and-references/modular-integrated-construction/index.html.



FAQ General 1.jpg

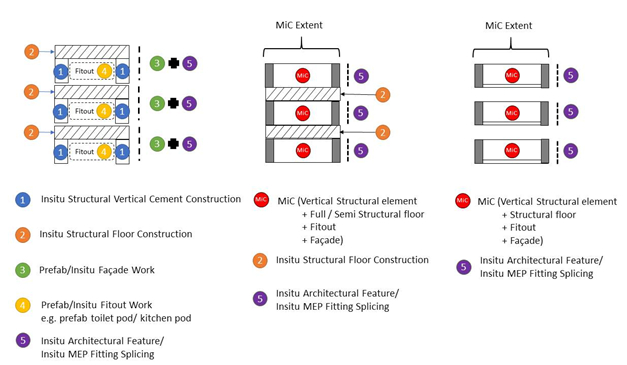

Figure 1 – Consideration of the Extent of Use of MiC

Q2. Is there any requirement on the minimum extent of the finishes, fixture, fittings, etc., to be qualified as MiC?

A2.

There is no requirement on the minimum extent.  As long as the system/components used satisfy the definition of MiC, they will be qualified.

Q3. Is there any requirement on the minimum percentage of the construction floor area (CFA) per floor to be constructed in MiC in order to be qualified as a MiC building and be entitled to the 6% GFA exemption as stipulated in PNAP APP-161?

A3.

There is no requirement on the minimum percentage.  As long as the system/components used satisfy the definition of MiC, they will be qualified.    APs and RSEs, however, are encouraged to devise a holistic scheme to maximize the benefits of adopting MiC with the minimum essential insitu construction with wet trades.

Q4. Can the 6% GFA exemption be obtained for a temporary MiC building? What is the definition adopted by BD for a “temporary building”? What is the design service life of a building for which BD submission is required?

A4.

Temporary buildings are those buildings defined under Building (Planning) Regulation 50, and they fall within one or both of the following categories: (a) buildings required only for a short time; (b) buildings constructed of short-lived materials and (c) buildings constructed as a contractor’s shed required in connection with the erection of permanent buildings.  As far as temporary buildings are concerned, all provisions of the BO and subsidiary legislation are equally applicable.  Thus, they are subject to approval and consent, supervision by an AP and/or a RSE, construction by a registered contractor, certification of completion and the issue of a temporary occupation permit (see PNAP APP-50).  The 6% GFA exemption is also applicable to temporary MiC buildings, as long as the system/components used satisfy the definition of MiC.

Q5. Is the 6% GFA exemption building subject to the overall GFA cap of 10% under PNAP APP-151?

A5.

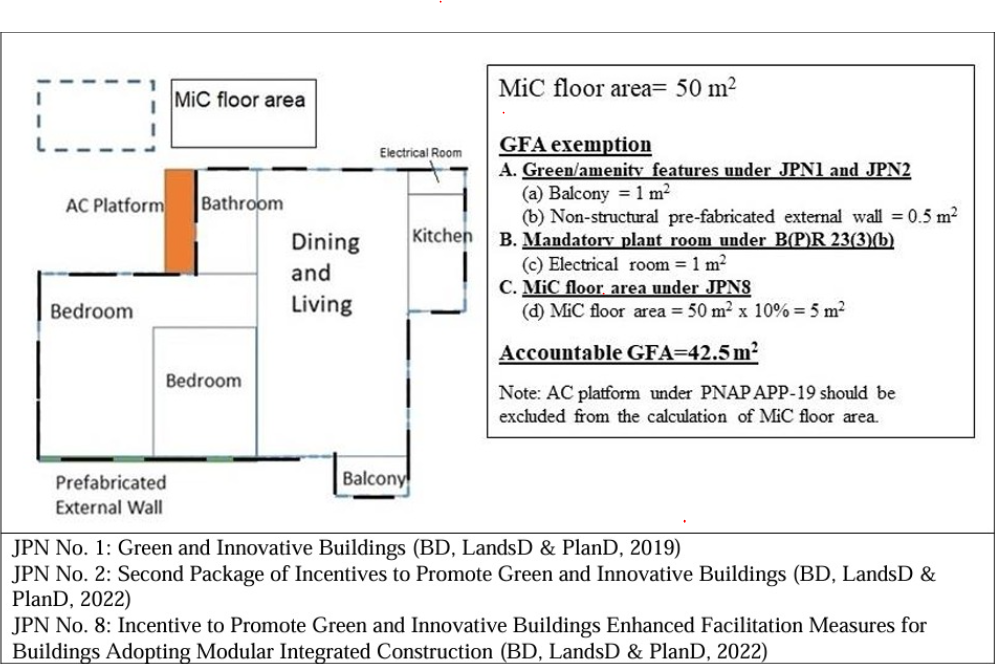

To encourage wider use of MiC in new buildings, the 6% GFA exemption of the MiC floor area of a new building is not subject to the overall GFA cap of 10% under PNAP APP-151.   An illustration example of the GFA calculations is given in Figure 2.

FAQ General 2.jpg

Figure 2 – Example of GFA Calculations

Last Updated: 23.12.2020 14:45:21

Transitional Housing Projects

In order to relieve the acute shortage of housing, the HKSAR Government announced the three-year transitional housing target of 15,000 units in January 2020. Up to now, two MiC transitional housing projects were completed, including the Nam Cheong 220 by The Hong Kong Council of Social Service and the Junction of Sung Wong Toi Road and To Kwa Wan Road Project by Lok Sin Tong. United Court by Sheng Kung Hui will be commenced shortly. The largest project in Kong Ha Wai by Pok Oi Hospital was commenced in March 2021. Over 6,000 people will be homed by the end of 2022.

江夏圍過渡性房屋計劃 - 首批示範單位落地元朗 (Chinese only)

10.06.2021 AluHouse

樂善堂社會房屋計劃「樂屋」 - 宋皇臺道及土瓜灣道交界組合屋項目 (Chinese only)

03.06.2021 Lok Sin Tong

江夏圍過渡性房屋項目正式動土 (Chinese only)

10.05.2021 City's Time

HOT TOPIC
